Planning · Sourcing Strategy

3 Weeks to Your Event:
Go or No-Go?

The most useful thing a supplier can tell you is sometimes no. This is an honest framework for deciding whether a custom inflatable can realistically make your event date.

6 min read·Published July 2026

A buyer recently came to us with an event twenty days out. We ran the numbers with her, and instead of taking the deposit, our salesperson wrote: “Since your event is on the 26th and I don't want to waste your time, I would honestly recommend considering an alternative.” This article is that conversation, turned into a framework you can run yourself.

3 Weeks to Your Event: Go or No-Go decision framework for custom inflatables | InflatCustom Blog

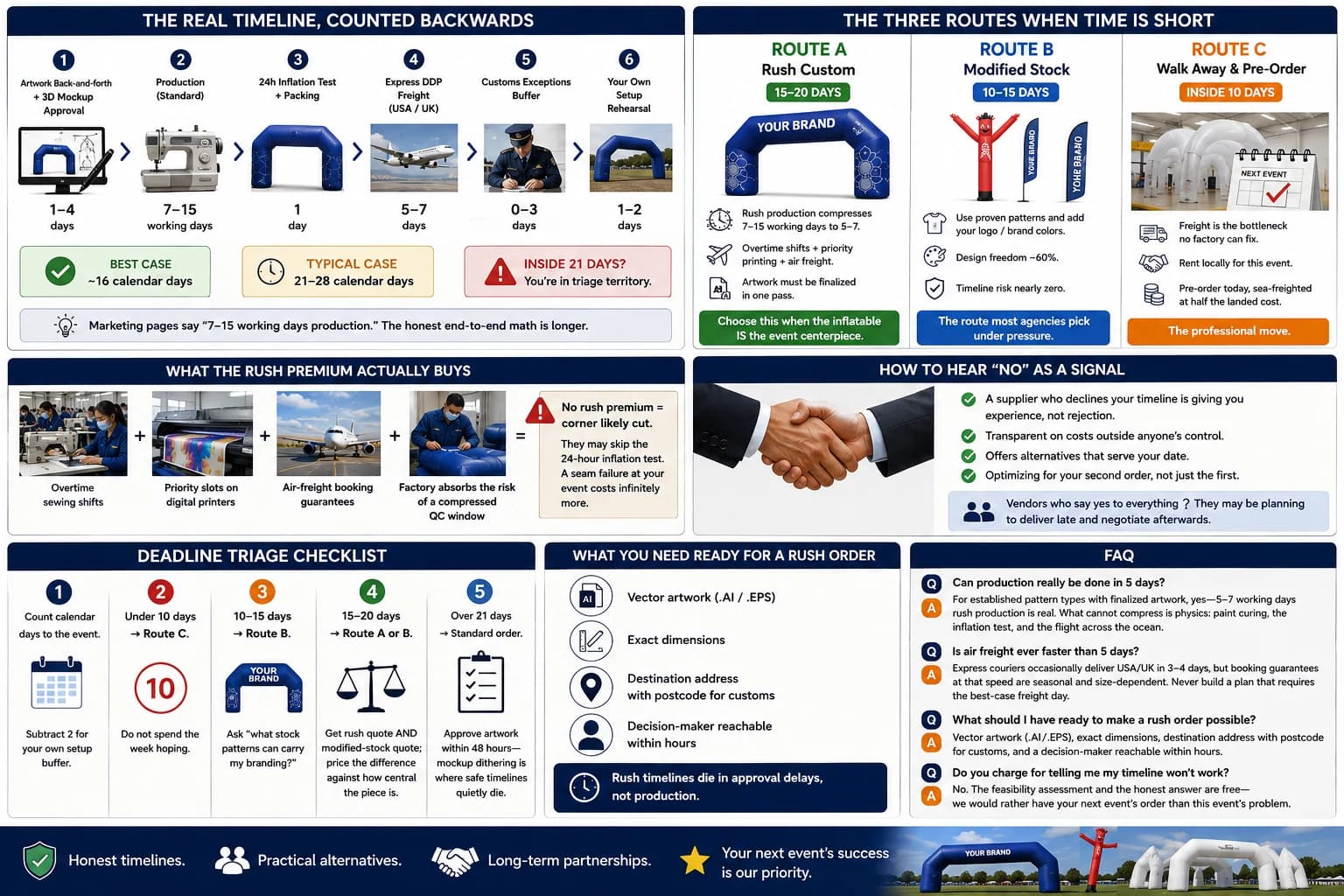

The Real Timeline, Counted Backwards

Marketing pages quote “7–15 working days production.” The honest end-to-end math for a custom inflatable is longer:

StageRealistic Duration
Artwork back-and-forth + 3D mockup approval1–4 days
Production (standard)7–15 working days
24h inflation test + packing1 day
Express DDP freight (USA/UK)5–7 days
Customs exceptions buffer0–3 days
Your own setup rehearsal1–2 days

Best case: about 16 calendar days. Typical case: 21–28. If your event is inside 21 days, you are in triage territory — which is not the same as impossible, but it means every decision now trades money or design freedom for time.

The Three Routes When Time Is Short

Route A — Rush custom (viable at 15–20 days). Rush production compresses 7–15 working days to 5–7 by jumping the queue and running overtime shifts. It costs a premium and it consumes your revision rounds: rush orders need artwork finalized in one pass. Choose this when the inflatable IS the event centerpiece and the design genuinely cannot compromise.

Route B — Modified stock (viable at 10–15 days). Factories keep proven patterns — arches, tube men, standard mascots, product-shape blanks. Adding your logo panel or brand-color sections to an existing pattern skips modeling and sampling entirely. Your design freedom drops to maybe 60%, your timeline risk drops to nearly zero. This is the route our salesperson recommended to the buyer with the event on the 26th — and the route most experienced event agencies pick under pressure.

Route C — Walk away and pre-order for next time (the underrated option). If you are inside 10 days, freight becomes the bottleneck no factory can fix. The professional move is renting locally for this event and placing the custom order today for the next one — arriving relaxed, sea-freighted, at half the landed cost.

The complete deadline framework: real timeline, three routes, rush premium and triage checklist for custom inflatables | InflatCustom Blog

What the Rush Premium Actually Buys

Buyers sometimes read rush fees as opportunism. Here is what they fund: overtime sewing shifts, priority slots on the digital printers, priority air-freight booking where available, and — critically — the factory absorbing the risk of a compressed QC window. A factory that quotes a rush job cheerfully at no premium is often leaving out one of the time-consuming checks that protects the final result. That is the corner you do not want cut, because a seam failure discovered at your event costs infinitely more than the fee.

How to Hear “No” as a Signal

A supplier who declines your timeline is handing you information: they have run this race before and know where it breaks. Note what our team actually did for the buyer with the event on the 26th — offered a product discount, was transparent that shipping costs were outside anyone's control, and recommended an alternative that served her date. Suppliers behave this way when they are optimizing for the second order, not the first. The vendors to worry about are the ones who say yes to everything; some of them are planning to deliver late and negotiate afterwards.

Deadline Triage Checklist

Run this before you contact any factory:

  1. Count calendar days to the event. Subtract 2 for your own setup buffer.
  2. Under 10 days → Route C. Do not spend the week hoping.
  3. 10–15 days → Route B. Ask “what stock patterns can carry my branding?”
  4. 15–20 days → Route A or B. Get the rush quote AND the modified-stock quote; price the difference against how central the piece is.
  5. Over 21 days → standard order, but it is still wise to approve artwork within 48 hours so the schedule has room for revisions.

Frequently Asked Questions

Can production really be done in 5 days?

For established pattern types with finalized artwork, yes — 5–7 working days rush production is real. What cannot compress is physics: paint curing, the inflation test, and the flight across the ocean.

Is air freight ever faster than 5 days?

Express couriers can sometimes deliver USA/UK in 3–4 days, but the result depends on season, route, parcel size and carrier capacity. Never build a plan that depends on the best-case freight day.

What should I have ready to make a rush order possible?

Vector artwork (.AI/.EPS), exact dimensions, destination address with postcode for customs, and a decision-maker reachable within hours. Rush timelines die in approval delays, not production.

Do you charge for telling me my timeline won't work?

No. The feasibility assessment and the honest answer are free — we would rather have your next event's order than this event's problem.

Related Resources

Get an Honest Deadline Check

Tell us your event date and what you need. We'll review whether it is feasible, which route fits, or when the honest answer is to plan for the next event window.

Check My Timeline

Start Your
Custom Project
Today

Our engineering team is ready to convert your brand identity into a massive, high-impact inflatable display.

Project Inquiry DeskSubmit at any time for a prompt professional response.

Global Standards

Project documents reviewed for destination and venue requirements.

Shipping Review

Export shipping options reviewed by destination, size and schedule.

Production Review Support

Project photos or video checks can be arranged before dispatch when confirmed in the order scope.

Only 4 fields required

Fast quote starts here

Optional project detailsAdd size, quantity, file or deadline if available.Add

B2B orders for events, agencies & brands. Product MOQ, timing and shipping route are reviewed by quotation.

Email Quote

Actively monitored. Your request goes directly to an export project specialist for a prompt, professional response.

Design Review Guidance

Factory-Direct Quote

Video Before Shipping
